Applications / Production and field

EVSE end-of-line testing for production

Test each charging station before it leaves production. Run a defined sequence, record the result against its serial number and identify units that need rework.

Our Easy Chester EOL and Easy Chester EOL HPC test systems bring this repeatable testing workflow to your production line.

Easy Chester EOL HPC production test rack
Unit-specific evidenceRecord identity, configuration, measurements and result together
Released test profilesExecute approved acceptance logic at the line
Automated decisionsRoute each unit to release, rework or review
Factory integrationConnect testing with line control, databases and reporting

The production outcome

Decide whether each charging station is ready for release.

Engineering approves the acceptance requirements. Production applies them to each identified charger and records the result.

Release

All mandatory checks were executed with the released profile and the unit met the approved acceptance criteria.

Rework

Route a known, repairable deviation to the defined rework process, then repeat the relevant checks.

Reject

The unit cannot be released because a mandatory criterion failed or the required test boundary could not be established.

Engineering review

Send unexpected results, test-system conditions or new product behaviour to engineering for analysis outside the standard line flow.

Production executes the test.Engineering defines the DUT scope, profile revision, limits, equipment assumptions and release rules.

Factory acceptance scope

Define the acceptance checks before choosing the tester.

Set the mandatory series checks for the charger family, market and interface. Keep type testing, development investigations and other quality processes separate from the released production acceptance plan.

Product identity

Serial number, production order, variant, options, firmware and other approved identity fields.

Charging interface

Connector and locking checks, Control Pilot (CP), Proximity Pilot (PP), PLC and CAN interfaces, and auxiliary signals.

Communication

Released charging protocol, expected sequence, configurable parameters, timing and selected negative reactions.

Electrical safety reactions

Selected charger-side protective behaviour, interlocks, isolation or residual-voltage checks where included in the production contract.

Functional charging

Connection states, enable conditions, contactor sequence, voltage and current response, start and controlled termination.

Power path

Defined source or load points, duration, ramps and limits sized to the production decision rather than a headline power value.

Metering option

Reference comparison at defined operating points when production also owns a metrology-oriented verification step.

Factory integration

Barcode, PLC, MES, QMS, database, report, operator guidance, rework routing and approved interfaces.

Scope boundary. Mechanical inspection, visual quality, dielectric tests, payment certification, backend acceptance and legal-market release remain separate unless the production project explicitly integrates them.

Controlled production cycle

Apply the approved profile and record the result for each unit.

The released profile gives production the approved test sequence, parameters and evaluation rules.

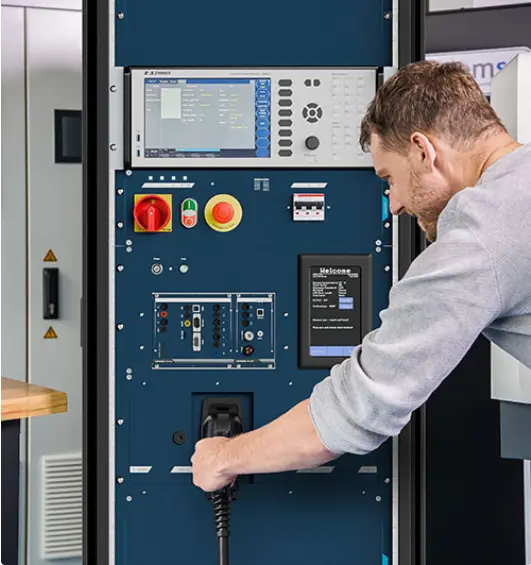

Production technician connecting an Easy Chester EOL system
Testing in production. The operator follows the released sequence and charging-specific acceptance rules.
  1. 1
    Identify the unit

    Read or enter the serial number, charger variant, firmware, order and other required production data.

  2. 2
    Load the released profile

    Select the approved test sequence and parameter set for the identified product configuration.

  3. 3
    Establish the protected test boundary

    Confirm connections, interlocks, external equipment and safe initial conditions before power is enabled.

  4. 4
    Execute the charging checks

    Run the released communication, function, parameter, safety-reaction and optional power or metrology steps.

  5. 5
    Evaluate automatically

    Apply the approved result logic, preserve measured values and make every deviation visible.

  6. 6
    Release, rework, reject or escalate

    Store the result and test record against the unit, then route the charger to the next production step.

Unit-level traceability

Link each result to the charging station tested.

Record the executed checks, approved profile and test conditions. Include the reason for release, rework, rejection or engineering review.

IdentitySerial number, product variant, production order and timestamp
Product stateFirmware, options, connector and configured market version
Test contractReleased profile, revision, limits and acceptance criteria
System stateTest hardware, software, external equipment and configuration
ExecutionPerformed, skipped and not-applicable steps with reasons
MeasurementRelevant signals, messages, timing, voltage, current and events
EvaluationStep verdicts, deviations, warnings and rework reason
OutputOverall decision, report, database record and retention route
Traceability belongs inside the test design.Record the identity and results throughout the test so they support the production decision before the report is exported.

Factory architecture

Integrate charging-specific tests into the production line.

Agree responsibilities for product identification, the EVSE (electric vehicle supply equipment, or charging station), external power and measurement equipment, automation and production data before integration.

Engineering

Maintain approved test requirements

Approve profiles, limits and configuration changes, and define when to involve engineering in diagnosis.

Production

Run the released sequence

Quality

Define acceptance and record retention

Define release evidence, audit needs, rework rules and record retention.

Factory IT

Connect the factory systems

Integrate barcode, PLC, MES, QMS, databases and approved data interfaces.

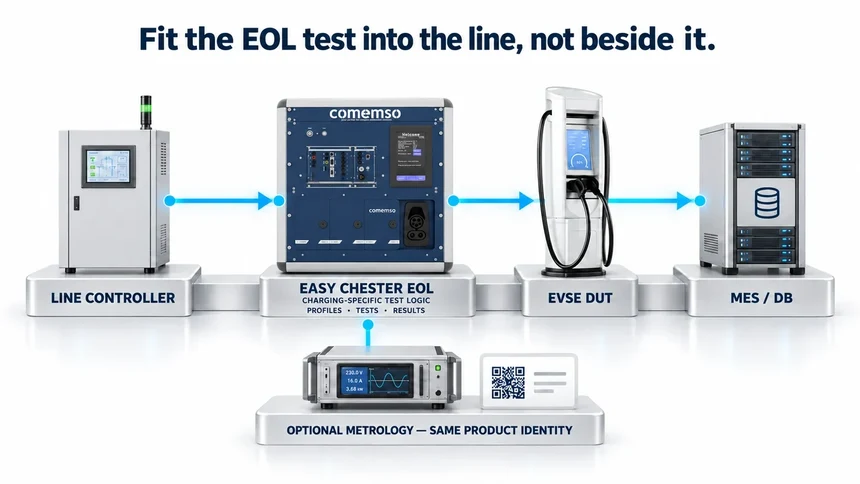

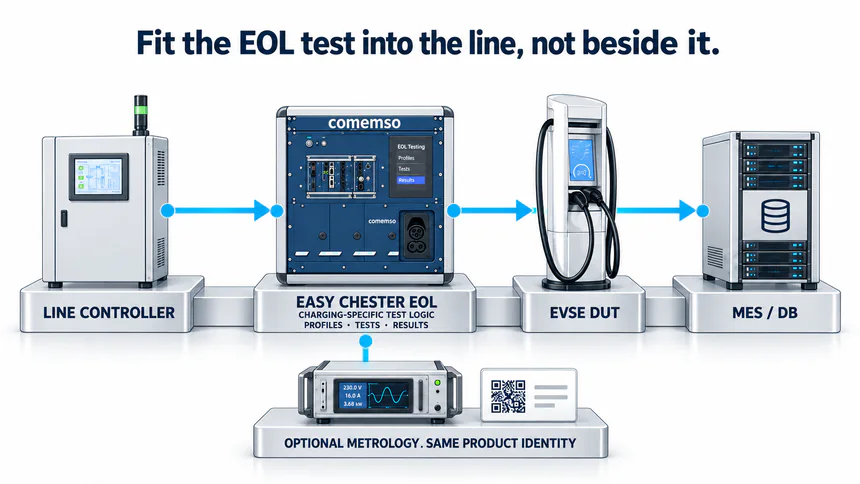

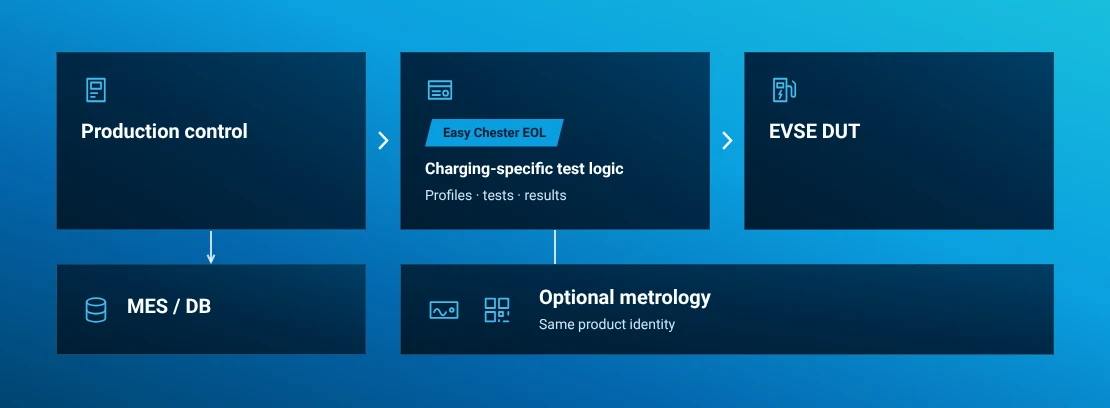

EVSE end-of-line integration between line control, Easy Chester EOL, the charging station and factory data systems
Configure the architecture for the production process, with defined responsibilities for external equipment.

System path

Choose the system for your production task.

Choose the system for your acceptance plan. Product pages cover hardware, ratings, interfaces, options and released functions.

Compact factory path
Easy Chester EOL

For repeatable EVSE function, communication and parameter checks with unit-level traceability in production.

Explore Easy Chester EOL
High-power factory path
Easy Chester EOL HPC

For DC fast-charger production with defined power operating points and a coordinated high-power test cell.

Explore Easy Chester EOL HPC
Metering at production
EOL plus Calibration

Add real energy transfer, a suitable AC or DC reference meter and metrological checks to the unit record.

Open application
Deeper engineering path
EVCA Flex

Use an open engineering environment for extensive fault simulation, power integration or deeper protocol analysis in production or during transfer.

Explore EVCA Flex
Automation and integration
comframe and APIs

Coordinate supported test equipment, customer-owned devices, automated sequences, evaluation, reporting and data handover.

Open software
Compare lifecycle roles
Easy Chester platform

Compare systems for factory acceptance, high-power production, field service and mobile calibration.

Compare systems

Requirements for the test setup

Specify the product, cycle, interfaces and required records.

DUT and variants

Complete EVSE or module, connector families, charging technologies, market versions, options and firmware.

Acceptance criteria

Mandatory communication, function, parameters, safety reactions, power points and pass/fail rules.

Cycle and throughput

Target takt time, repetitions, stabilization, peak and continuous duty, shift model and maintenance window.

Power architecture

Independent voltage, current, power, duration, regeneration, cooling, switching and facility constraints.

Automation

Operator guidance, remote control, line PLC, robotics, barcode, sequence ownership and safe-state handling.

Data interfaces

MES, QMS, database, file exchange, APIs, result acknowledgement and offline behaviour.

Evidence and retention

Required fields, raw data, step results, reports, signatures, audit trail, storage location and retention period.

Optional metrology

Reference meter, range, uncertainty, traceability, procedure, operating points and responsible legal or quality process.

Selection rule. Do not size the system from one maximum-power number. Specify the test point, duration, repetition, thermal duty, required evidence and factory integration separately.

Published implementation examples

Integrate customer-specific equipment into a standard test workflow.

May 2025

Customer-owned power electronics inside one EOL workflow

A customer combined Easy Chester EOL with internally developed power electronics for a specific production setup. Standard Easy Chester operation is designed to work without a laptop; production interfaces are specified separately.

Read the customer project
April 2024

Use consistent test data in development and production

A portable EVCA Flex unit supported development, while a smaller rack system tested at the production site. Shared test and measurement data helped keep the engineering and factory results consistent.

Read the system story
Common principle.Different factory equipment can be integrated. Keep the approved test requirements, unit identification and decision records consistent throughout the workflow.

Frequently asked questions

EVSE end-of-line testing

What is EVSE end-of-line testing?

EVSE end-of-line testing checks a completed charging station or defined production module against approved factory acceptance criteria before release. Each test record links the unit identity, released configuration, executed checks, measurements and final result.

How does end-of-line testing differ from development validation?

Development validation explores behaviour, limits, robustness and faults as the product changes. End-of-line testing repeatedly applies the released acceptance plan to manufactured units, with a focus on consistent results, cycle time, traceability and release decisions.

What should be checked on every manufactured charging station?

The exact scope is product-specific. Typical checks can include unit identity, charging-interface behaviour, low-level signals, high-level communication, functional charging, selected electrical-safety reactions, configured parameters and production evidence. Mechanical, visual and regulatory checks remain separate unless explicitly integrated.

How is the test result linked to the charger serial number?

Read or receive the unit identity, load its released profile and store the test configuration, measurements, step results and overall result under that identity. Specify the barcode, database, MES or QMS interface for the production project.

Can one test station handle several EVSE variants?

Yes, if the hardware supports the required interfaces and every variant has a released test profile. Select the variant from the production identity or an approved operator workflow, then use its defined sequence for each unit.

Can customer-owned power electronics or factory equipment be integrated?

Yes, within a defined integration scope. comframe and released interfaces can coordinate supported external sources, loads, meters, line controllers and databases. The May 2025 customer project integrated customer-owned power electronics through the Generic Source API.

Choose EVSE testing for field and production

For commissioning and service, the CCS EVSE tester route leads to the appropriate field test. Production workflows instead need a DUT connection, automatic sequence and result association. Select the required interfaces and released profiles for each task; Micro remains an AC installation tester.

Production test planning

Plan the release process for each charging station.

Agree the unit identity, approved test profile, cycle time, acceptance criteria and rework path. Translate the production process into the required EOL configuration and line interfaces.
